Busek Company, Inc.¶
Investigated: 2026-04-05 (Session 2) | Updated: 2026-04-07 (Session 70)
Summary¶
Busek's FO project (91700) for an iodine RF ion thruster was CANCELED by another NASA program in 2016 at TRL3. Yet Busek went on to commercialize the technology independently: the BIT-3 became the world's first gridded ion thruster to operate on iodine propellant, and flew on two missions aboard NASA's SLS Artemis-1 (Lunar IceCube and LunaH-Map, launched November 16, 2022). USASpending shows $80M+ in cross-agency contracts (updated Session 31). This is the clearest example in the FO portfolio of canceled project → successful commercial product — the FO cancellation was irrelevant to the technology's ultimate success.
Outcome category: Commercial product + DoD adoption — the FO cancellation was a non-event; Busek already had parallel NASA/DoD funding streams
FO Project¶
Project 91700 — Iodine Radio Frequency (RF) Ion Thruster Development Testing¶
- Period: 2013-08-16 to 2016-05-11
- Status: CANCELED
- TRL: 3 → 3 (no gain — canceled before flight test)
- Program: FO
- PI: Kurt Hohman
- Co-investigators: Roy E. Martin, Michael Tsay
- Outcome fields: Advanced From (Other) | Canceled (Other NASA Program or Directorate)
- Key note: Canceled by "another NASA program" — likely a scheduling conflict with another Busek contract, not a technical failure
The BIT-3 Product Line¶
Busek developed the BIT-3 (Bus-powered Iodine Thruster, 3W class) as a commercial CubeSat propulsion product:
- World's first gridded ion thruster to use iodine propellant
- Performance: 1.1–1.24 mN thrust, 2,150–2,250s specific impulse, 56–75W input power
- Key advantage: Iodine stores as dense solid (>2x storage density vs. xenon) — eliminates high-pressure tanks
- Self-contained: Integrated control electronics, iodine storage/feed, thruster, neutralizer, optional gimbal
PI Michael Tsay (Co-I on the FO project) is the BIT-3 lead engineer. He is the continuity between the canceled FO work and the commercial product.
Artemis-1 Flights (November 16, 2022)¶
Two BIT-3-powered CubeSats launched as SLS Artemis-1 rideshares:
-
Lunar IceCube (Morehead State University) — BIT-3 to inject into lunar capture orbit at ~100 km altitude. Ground contact established Nov 17 2022; mission team continued communication attempts. Science orbit achievement status uncertain.
-
LunaH-Map (Arizona State University) — BIT-3 powered, deep-space lunar mapping. Propulsion failure: Doppler ranging showed a valve was partially stuck, allowing some iodine through but not enough for required thrust. Engineers attempted to free it with heaters but the spacecraft could not execute the lunar flyby maneuver. This is a meaningful data point: BIT-3's first deep-space flights revealed a valve reliability issue.
Gen-2 BIT-3 systems have since been developed with upgrades from the Artemis-1 flight models, each capable of 1.1 mN thrust, 2,150 sec Isp, and 31.7 kN-sec total impulse at 75W.
NASA contract link: NNX15CC90C ($2M, 2015–2021) = "Busek in partnership with Morehead State University — develop a versatile 6U CubeSat capable of reaching a lunar orbit from GEO." This is the Lunar IceCube development contract.
FO Parallel vs. Sequential Narrative¶
The FO project (2013–2016) and the Lunar IceCube development (NASA contract 2015–2021) overlapped in time. Busek was developing the BIT-3 on multiple funding streams simultaneously — the FO cancellation in 2016 was not a setback but a minor disruption in a broader program. The DoD Air Force contract FA881415C0005 ($1.5M, 2015) for "Iodine Satellite Technical Maturation" shows Air Force support beginning before the FO cancellation.
2013: FO contract starts (TRL3 iodine ion thruster)
2013: NASA Phoenix Technologies contract ($2.34M) — space servicing work
2015: AF "Iodine Satellite Technical Maturation" ($1.5M)
2015: NASA Lunar IceCube contract ($2M) with Morehead State
2016: FO project CANCELED by other NASA program
2022: BIT-3 flies on Artemis-1 SLS (Lunar IceCube + LunaH-Map)
2023: $7.33M AF propulsion contract; $3.38M NASA BET-MAX contract
2026: $1.78M NASA Habitable Worlds Observatory contract (active)
USASpending Portfolio (Selected)¶
DoD contracts (larger awards): | Award ID | Amount | Agency | Description | Period | |----------|--------|--------|-------------|--------| | FA930023C6007 | $7.33M | AF | Propulsion system for propellant | 2023–2027 | | FA930012C3000 | $4.95M | AF/DCMA | SBIR Phase III — Space Plasma Characterization Source | 2012–2021 | | FA880820C0041 | $4.72M | AF | Hall effect thruster capability study | 2020–2024 | | FA930008C0005 | $4.70M | AF | FalconSat-5 SBIR Phase III | 2008–2010 | | FA881420C0001 | $3.00M | AF | Satellite on Umbilical Line system | 2020–2022 | | N0003917C0004 | $2.90M | Navy | SeaCube ocean altimeter for CubeSats | 2017–2019 | | FA930021C6012 | $2.81M | AF | SmallSat electrospray thruster development | 2021–2026 | | FA930021C6001 | $2.57M | AF | Mid-power Hall thruster system demonstration | 2020–2024 |
NASA contracts (selected): | Award ID | Amount | Agency | Description | Period | |----------|--------|--------|-------------|--------| | 80NSSC23CA212 | $3.38M | NASA | High total impulse BET-MAX deorbit system | 2023–2026 | | NNX16CC02C | $2.48M | NASA | BET-100UN CubeSat prototype (GCT program) | 2016–2018 | | NNA12AB12C | $2.34M | NASA | Phoenix Technologies space servicing | 2012–2015 | | NNX15CC90C | $2.00M | NASA | Lunar IceCube development (direct BIT-3 pathway) | 2015–2021 | | 80GSFC26C0012 | $1.78M | NASA | Habitable Worlds Observatory tech demo | 2026–2029 | | NNL13AA13C | $1.65M | NASA | Miniature electrospray thrusters | 2013–2015 | | NNX14CC24C | $1.62M | NASA | Hall thruster (15-kW class) | 2014–2018 | | + many Phase I/II SBIRs | ~$8M | NASA | Various propulsion topics | 2012–2023 |
New awards (Session 31 update):
| Award ID | Amount | Agency | Description | Period |
|---|---|---|---|---|
| FA864923P1091 | $1.25M | AF | SOUL system for Active Debris Removal | 2023–2025 |
| FA864923P1216 | $1.25M | AF | Flexible Fuel Electron Source for space propulsion | 2023–2025 |
| FA930024C6002 | $750K | AF | Thermal improvement on Newton Thruster | 2024–2026 |
| FA864924P0922 | $75K | AF | Phase I: 10 kW PPU for Hall thrusters | 2024 |
| HQ085926FF411 | $500 | MDA | SHIELD initial order (multi-year vehicle) | 2025–2035 |
Estimated total tracked (NASA + DoD): ~$97M+
Busek is an extremely active SBIR company across NASA and DoD — clearly one of the major electric propulsion small businesses in the US. The HWO contract (2026–2029) marks expansion into flagship science mission propulsion, while MDA SHIELD opens a missile defense avenue.
Session 70 additions (not in tables above):
| Award ID | Amount | Agency | Description | Period |
|---|---|---|---|---|
| FA930023C6007 | $14.3M | AF | ASCENT Hall Thruster — green propellant proto-flight system | 2023–Mar 2027 |
| FA930021C6012 | $2.81M | AF | SmallSat electrospray thruster system development | 2021–Mar 2026 |
| FA930022C6033 | $750K | AF | High-density plasma thruster | 2022–Dec 2025 |
Session 35 Update: Gateway PPE + Artemis-1 Mission Outcomes¶
Gateway PPE — BHT-6000 Hall Thrusters (MAJOR DEVELOPMENT):
Busek delivered all four BHT-6000 (6 kW) Hall effect thrusters to Maxar Space Systems for NASA's Lunar Gateway Power and Propulsion Element, confirmed September 15, 2025. This is their highest-profile hardware delivery — the first US electric propulsion on a human-rated mission. The PPE system (4× BHT-6000 + 3× 12 kW engines from another vendor) is 30% more powerful than any previous in-space solar electric propulsion system.
Artemis-1 CubeSat Missions — Both Failed: - Lunar IceCube (Morehead State): Brief contact (~1 hour carrier signal via DSN) on Nov 17, 2022. Communication lost and never re-established. Spacecraft never reached science orbit. Mission lost. - LunaH-Map (ASU): Iodine propulsion valve became partially stuck Nov 2022. Six months of heating attempts failed. NASA ceased operations May 2023. Spacecraft entered heliocentric orbit. Partial science: neutron spectrometer collected ~3 hours of data during lunar flyby at ~1,300 km, validating water ice detection capability. Mission failed but instrument validated.
OneWeb — BHT-350 Production:
80 OneWeb satellites with BHT-350 Hall thrusters commissioned on orbit (launched Dec 2022/Jan 2023). Busek ramped production to 20 thrusters/month with capacity to double or triple.
Company Profile (Session 35):
~60 staff (target ~75), ~$9.4M annual revenue (likely understated), 50,000 sq ft facility in Natick MA with room to double. Privately held, no VC. Revenue is contract-driven.
Confidence Assessment¶
| Claim | Confidence | Evidence |
|---|---|---|
| BIT-3 is world's first iodine gridded ion thruster | confirmed | Busek website; academic papers |
| BIT-3 flew on Artemis-1 Lunar IceCube | confirmed | Multiple news sources; Wikipedia |
| FO project 91700 canceled by other NASA program | confirmed | TechPort outcome field |
| $80M+ cross-agency contracts | confirmed | USASpending (updated Session 31) |
| FO cancellation was non-causal to BIT-3 development | confirmed | Parallel funding streams documented |
Key Insight¶
The "Canceled" status in TechPort is not predictive of commercial failure. Busek's iodine thruster work continued through AF and NASA SBIR channels regardless of the FO cancellation. The FO project was simply one node in a dense multi-agency funding network. The real question for canceled FO projects is: did the underlying work continue? For Busek, clearly yes.
Second FO Project: 1U CubeSat Green Propulsion System¶
FO Project: 91635 — 1U CubeSat Green Propulsion System with Post-Launch Pressurization Testing
Period: 2013-08-16 – 2017-08-14
TRL: 3 → 3 (zero gain)
PI: Michael Tsay (Co-I on the main FO project [91700]; PI here)
A separate FO project from the iodine thruster [91700], running concurrently. The 1U green propellant CubeSat system used a "non-toxic green propellant" with an "innovative post-launch pressurization scheme" — completely unpressurized at launch to minimize hazards, suitable for rideshare.
Outcome: TRL 3→3, zero gain. This project also ended without a flight demonstration. The specific propellant/technology is not identified in TechPort (green propellant could be AF-M315E/ASCENT, LMP-103S, or similar).
Pattern: Busek ran two FO projects simultaneously (2013–2017) — the iodine ion thruster [91700] and the green propellant 1U system [91635]. Both had zero TRL gain due to program issues. Yet Busek's actual commercial portfolio (BIT-3 iodine thruster, electrospray thrusters) continued to thrive. Again reinforces: FO project outcomes for Busek are irrelevant to company-level success.
Co-Is on [91635]: Eric H Cardiff (NASA Goddard), Derek Lafko, Roy E. Martin — the NASA Goddard co-I suggests this was testing a Green Propellant Infusion Mission-adjacent technology.
Session 36: FO → Gateway PPE Causal Analysis¶
Question: Did Busek's FO iodine thruster work (project 91700, 2013–2016) contribute to the BHT-6000 Hall thrusters now on Gateway PPE?
Answer: No direct causal link. Completely independent product lines.
The Hall thruster → Gateway chain is fully traceable through TechPort SBIRs, with different PIs, different technology, and a different prime partner:
BHT lineage (Hall effect thrusters — PI: Bruce Pote):
SBIR Phase I [9335] (2012): Iodine Hall Thruster feasibility — TRL 3→4
SBIR Phase I [9438] (2012): Wide Throttling Hall Thruster — TRL 3→4
SBIR Phase II [12851] (2013–2015): Wide Throttling HET — TRL 3→5
SBIR Phase I [16574] (2013): 15 kW flight HET — TRL 5→5
SBIR Phase II [NNX14CC24C] ($1.62M, 2014–2018): 15 kW class Hall thruster
CCRPP [102912] (2017–2019): Multi-kW HET Qualification Life Test — TRL 6→7
→ SSL/Maxar as commercialization partner and investor
→ Explicit goal: replace Russian OKB Fakel as US industrial base
→ BHT-6000 delivered to Maxar for Gateway PPE (Sep 2025)
BIT-3 lineage (gridded ion thruster — PI: Michael Tsay):
FO [91700] (2013–2016): Iodine RF ion thruster — CANCELED at TRL 3
FO [91635] (2013–2017): Green propulsion — TRL 3→3 (zero gain)
NASA [NNX15CC90C] ($2M, 2015–2021): Lunar IceCube BIT-3
AF [FA881415C0005] ($1.5M, 2015): Iodine satellite maturation
→ BIT-3 flew on Artemis-1 (Nov 2022) — both missions failed
Key evidence from TechPort [102912] description: "Space Systems/Loral, LLC (SSL) is both the commercialization partner and the investor into the CCRPP program... SSL leads the World in the number of satellites flying Hall thrusters. To date their preferred supplier has been OKB Fakel of Russia. Busek's development and commercial supply for SSL, significantly strengthens the US Industrial base." SSL became Maxar, the Gateway PPE prime.
Indirect connections (weak): - Both product lines exist within the same ~60-person company — shared facilities, overhead, institutional knowledge - Revenue from BIT-3 and ion thruster contracts helped sustain the company, indirectly enabling Hall thruster investment - Iodine propellant expertise has some crossover: TechPort [18048] describes a Hall thruster that "could be fueled by either xenon or iodine" - Michael Tsay (FO PI) and Bruce Pote (Hall PI) are colleagues at the same company
Conclusion: The FO contribution to Busek's biggest achievement (Gateway PPE) is negligible to zero at the technology level. The Hall thruster lineage was funded through NASA SBIRs (2012+) and commercialized through SSL/Maxar — a pipeline that operated entirely independently of FO. The FO cancellation was irrelevant not just to BIT-3 (as previously noted) but also to the Hall thruster program. Busek's FO projects were a minor sideshow in the context of a company running 20+ concurrent NASA/DoD propulsion contracts.
Confidence: Confirmed — based on TechPort structured lineage, USASpending contracts, PI assignments, and project descriptions.

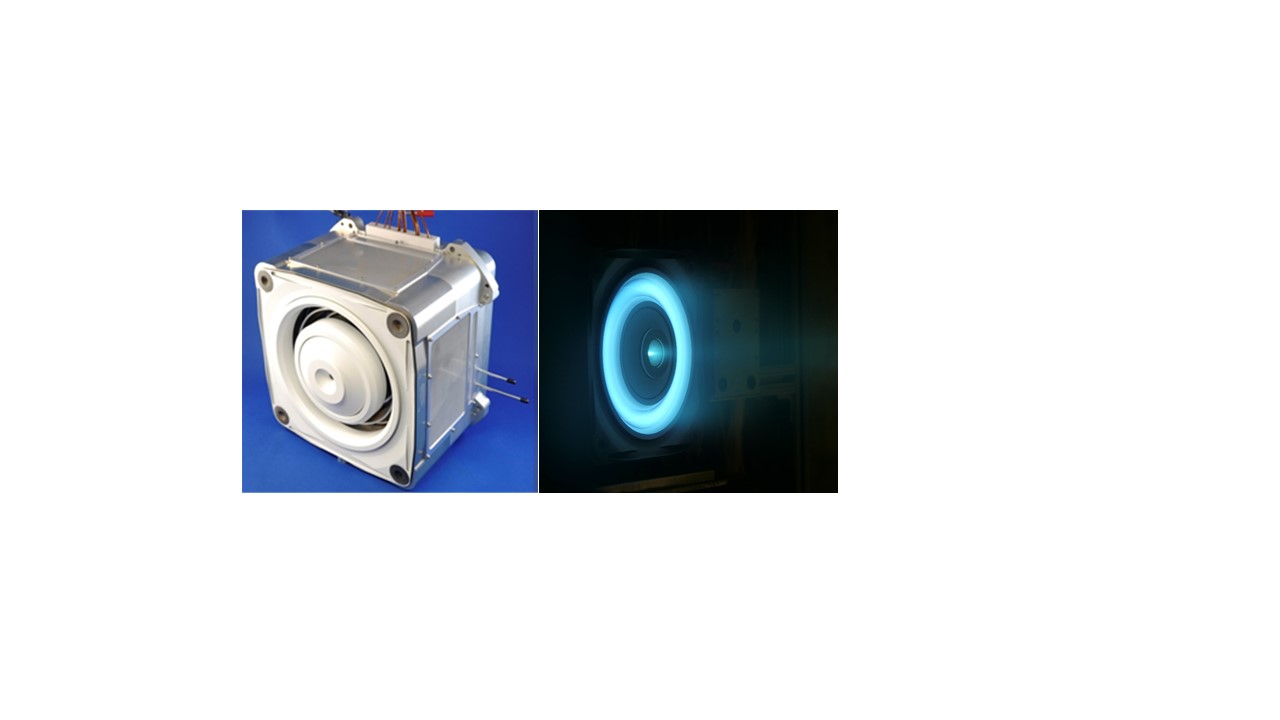

BHT-5000/6000 engineering model (left) and firing test (right). From TechPort 102912.
Session 38: Gateway Cancelled → SR-1 Freedom Mars Mission¶
MAJOR DEVELOPMENT: NASA suspended the Lunar Gateway program indefinitely in March 2026, pivoting to a lunar surface base strategy (2029–2036). The PPE hardware — including Busek's four BHT-6000 Hall thrusters — has been repurposed for Space Reactor-1 Freedom (SR-1), a nuclear electric propulsion mission to Mars:
- Mission: SR-1 Freedom — first US nuclear fission-powered interplanetary spacecraft
- Launch: End of 2028
- Destination: Mars (arrives ~1 year after launch)
- Propulsion: PPE solar electric propulsion (Busek BHT-6000 × 4 + AEPS × 3) mated with a closed Brayton cycle fission reactor (>20 kW)
- Payload: SkyFall — 3 helicopters (Ingenuity-derived) to scout human landing sites and search for subsurface water ice
- Significance: Busek's BHT-6000 thrusters go from the first US electric propulsion on a human-rated cislunar station to the first US nuclear-electric interplanetary spacecraft
Impact on Busek: Net positive. The hardware is already delivered (Sep 2025). A Mars mission is arguably higher-profile than Gateway orbit maintenance. The SR-1 mission demonstrates Busek hardware in a deep-space, multi-year cruise — far more demanding than cislunar operations.
Updated timeline:
2012: SBIR Phase I — Iodine Hall Thruster feasibility [9335]
2013: FO project [91700] starts (iodine ion thruster, CANCELED 2016)
2015: NASA Lunar IceCube contract ($2M) — BIT-3 development
2017: CCRPP [102912] — BHT-6000 qualification with SSL/Maxar
2022: BIT-3 flies on Artemis-1 (both missions failed)
2022: OneWeb BHT-350 constellation production (80 satellites)
2025: BHT-6000 × 4 delivered to Maxar for PPE (Sep 2025)
2026: Gateway suspended (Mar 2026); PPE → SR-1 Freedom (nuclear reactor replaces solar arrays)
2026: HWO contract ($1.78M, active); BET-300P electrospray first space deployment
2027: ASCENT green propellant Hall thruster proto-flight delivery (Mar 2027)
2028: SR-1 Freedom launch Dec 2028 → Mars (~1 year transit); BHT-6000 thrusters on nuclear-electric power
Session 70: ASCENT Contract + Production Milestones¶
ASCENT Hall Thruster ($14.3M, USAF): FA930023C6007 — Advanced Spacecraft Energetic Non-Toxic (ASCENT) Hall Thruster System Development. Proto-flight unit using green ASCENT propellant (10% higher Isp, 45% greater density than hydrazine). Work at Natick MA + Edwards AFB. Completion Mar 2027. This is Busek's largest single DoD propulsion contract and represents the push into green propellant Hall thrusters.
Production milestones (2025–2026): - 100+ BHT-350 thrusters launched in the past 12 months (OneWeb + others) — up from 80 previously tracked - BET-300P electrospray thrusters deployed in space — first orbital use of Busek's electrospray product line - BHT-600 orbital debut imminent — 200–800W mid-range Hall thruster; completed 7,198-hour endurance test at NASA Glenn; first flight unit shipped Feb 2021; orbital debut "coming soon" - Additional BIT-3 flights beyond Artemis-1 claimed
HWO congressional context: HWO funding boosted to $150M in FY2026 minibus appropriations (vs. $3.3M proposed). Busek is one of 7 companies selected (alongside Astroscale, BAE, L3Harris, Lockheed Martin, Northrop Grumman, Zecoat).
Revised total tracked: ~$97M+ (adding $14.3M ASCENT + $2.81M electrospray + $0.75M plasma thruster to prior $80M+)
Open Threads¶
- ~~Did Lunar IceCube enter science orbit?~~ Resolved Session 35: No — mission lost.
- ~~LunaH-Map valve issue?~~ Resolved Session 35: Mission failed. Valve stuck; partial instrument validation.
- ~~Michael Tsay role?~~ Resolved Session 35: Director, Electrothermal Propulsion Group.
- ~~FO→Gateway causal link?~~ Resolved Session 36: No direct link. Independent product lines, different PIs, different technology.
- ~~Gateway PPE launch timeline~~ Resolved Session 38: Gateway cancelled Mar 2026. PPE repurposed for SR-1 Freedom Mars mission (launch end 2028).
- ~~BIT-3 commercial sales~~ Partially resolved Session 70: Busek states "iodine BIT-3s placed in space" beyond Artemis-1 — specific missions TBD
- ~~SR-1 Freedom mission details~~ Resolved Session 70: BHT-6000 confirmed retained on PPE; nuclear reactor replaces solar arrays; launch Dec 2028
- OPEN: HWO electrospray microthrusters — confirm when details emerge
- OPEN: BHT-600 orbital debut — "coming soon" per Busek; 7,198-hr endurance test completed; first flight unit shipped Feb 2021
- OPEN: BET-300P electrospray first space deployment — Busek claims it's deployed; specific mission TBD
